June 12, 2026
If you are planning a new supermarket, the first question is rarely about cost. It is about time. Your opening date drives everything else. Lease commitments, staff recruitment, stock orders, marketing spend and revenue forecasts all hang off the day the doors open. Get the timeline wrong and every one of those decisions becomes more expensive.
So here is the short answer. A new build supermarket in the UK typically takes 18 to 30 months from site acquisition to trading. The construction phase itself usually takes 6 to 10 months for a standard format store. A conversion of an existing building can cut the on site period to 4 to 6 months.
Those are wide ranges, and the difference between the bottom and top of each range is rarely down to the builder. It is down to planning, utilities and decisions made before anyone breaks ground. This guide walks through every phase, gives realistic durations for each, and explains where programmes actually gain and lose time. We have delivered eleven stores for Lidl, so the durations below come from real programmes, not theory.
Here is how a typical new build supermarket programme breaks down:
Some of these phases overlap. A good contractor will run procurement during planning and start fit out trades before the envelope is fully complete. That overlap is where experienced teams claw back months. But the sequence above is the honest shape of a supermarket programme, and skipping a phase on paper does not make it disappear on site.

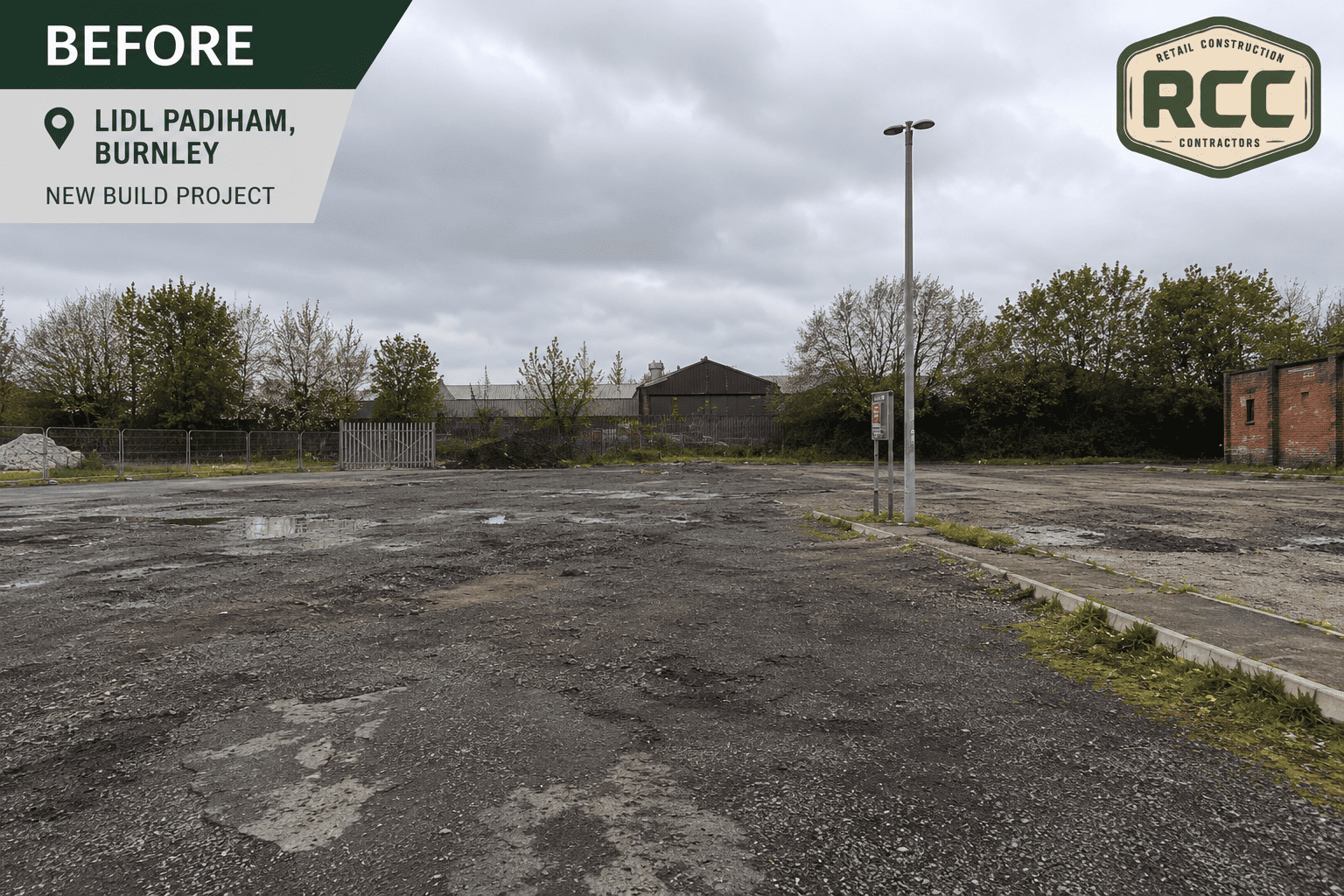

Before design starts, you need to know the site can actually take a supermarket. This phase answers three questions. Can you build what you want here? Will the council let you? And what will the ground cost you?
Feasibility work typically covers site surveys, ground investigation, access and highways assessment, flood risk, contamination checks and a review of local planning policy. None of this feels like progress because nothing visible happens. But weak feasibility work is the single most common root cause of delays that surface a year later. A contaminated site discovered during groundworks can add three months and six figures. The same discovery during feasibility costs you a report and a negotiation on the land price.
What you should do in this phase: involve a contractor early. Most developers bring construction expertise in after planning. By then the big buildability decisions are already locked in. A contractor reviewing the site at feasibility stage will flag access constraints, crane positions, utility capacity and ground risks while you can still do something about them.
Design for a supermarket is faster than for most commercial buildings because the formats are well established. The major operators work to standardised store layouts, which compresses design time significantly. A discounter format store has a known footprint, a known structural grid and a known services strategy. Design becomes a process of adapting a proven template to the site rather than starting from a blank page.
The pre application process with the local authority sits inside this phase. A formal pre application enquiry is not mandatory, but for retail schemes it is almost always worth the time. It surfaces objections early, signals what conditions the council is likely to attach, and reduces the risk of a refusal that costs you six months in appeal or redesign. The Planning Portal sets out how the pre application process works and what most authorities expect.
This is where timelines stretch, and where you have the least control.
The statutory determination period for a major application is 13 weeks. Treat that number with caution. In practice, retail applications regularly take longer because of three things:
Realistic planning durations: a straightforward application on an allocated retail site might complete in 4 to 5 months. A contested application with retail impact objections and a Section 106 agreement can take 9 months or more. Budget your programme on the cautious end and treat anything faster as a bonus.
One practical point. Permission almost always comes with pre commencement conditions, which are requirements you must discharge before starting on site. Materials approvals, drainage details, construction management plans and ecology measures are typical. Discharging conditions takes the council up to 8 weeks per submission. Developers who treat the decision notice as the finish line lose 2 to 3 months here. Developers who prepare condition submissions during the planning period lose almost none.
Once planning is secured, the project moves into pre construction. This covers detailed technical design, building regulations approval, procurement of the supply chain, and mobilisation.
This phase is where the contractor model you choose starts to affect the programme. A traditional main contractor spends much of this period tendering packages to subcontractors, comparing bids and negotiating terms. Each package tender takes weeks, and the programme cannot be locked until the supply chain is. A contractor with an in house workforce skips most of that. The teams that will deliver the groundworks, structure and fit out already exist, their availability is known, and the programme can be committed earlier and with more confidence.
The other critical task in this phase is utility applications. Supermarkets are power hungry buildings. Refrigeration, bakery ovens and EV charging push electrical demand well beyond a standard commercial connection, and new substations or network upgrades have long lead times. Utility connections are one of the most common causes of late stage delay in food retail, and the application should go in the moment planning looks likely, not when the frame is up.
On site at last. Groundworks covers site clearance, excavation, foundations, drainage and the ground floor slab.
The range here is driven almost entirely by ground conditions. Good bearing ground with no contamination sits at the bottom of the range. Poor ground needing piled foundations, soil stabilisation or remediation sits at the top, and in bad cases beyond it. This is why the ground investigation in Phase 1 matters so much. The ground does not get better because the programme needs it to.
Weather is the other variable. Groundworks in a wet winter run slower than groundworks in a dry summer. If your programme allows any flexibility on start date, starting groundworks outside the worst of the winter months buys real protection.
Most UK supermarkets are steel portal frame buildings. The frame itself goes up fast, often in 2 to 3 weeks, and it is the most visible progress on the whole programme. The roof, cladding, glazing and curtain walling follow, taking the building to weathertight.
Weathertight is the milestone that matters. Once the envelope is sealed, internal trades can start regardless of weather, and the programme becomes far more predictable. Experienced contractors sequence the envelope to get the building sealed as early as possible, even if external finishing work continues afterwards.
External works run in parallel through this phase. Car parking, service yards, access roads, landscaping and signage. The car park matters more than many developers expect. It is a large area of drainage, sub base and surfacing, and on constrained sites it competes with the building for space, cranage and deliveries. Sequencing the externals badly is a classic way to lose a month without anyone noticing until it is gone.
The fit out phase turns a weathertight shell into a trading store. Mechanical and electrical installation, refrigeration, flooring, ceilings, internal partitions, cold rooms, checkouts, racking and lighting.
Refrigeration is the long pole. Refrigeration packs, cases and cold rooms have long manufacturing lead times and a fixed commissioning sequence. The system must be installed, gas charged, commissioned and temperature proven before stock can arrive. If refrigeration is ordered late, nothing else in the fit out can compensate. This is a procurement decision made in Phase 4 that decides whether Phase 7 runs to programme.
Coordination is the other challenge. A supermarket fit out puts a dozen trades in the same building at the same time, and the interfaces between them are where delays breed. This is where the contrast between a subcontracted model and an in house model is sharpest. When the M&E team, the flooring team and the shopfitting crew all answer to the same employer, sequencing disputes get resolved in a morning site meeting rather than through contractual correspondence. Our retail fit out page covers how we run this phase in more detail.
The final phase covers testing and commissioning of all building systems, statutory sign offs, snagging and the formal handover to the operator.
For a food store, handover is not the end of the timeline that matters to you. After handover comes merchandising, stock fill, staff training and soft launch, typically 2 to 4 weeks run by the retailer. When you plan backwards from a public opening date, build that retailer period in. A handover date that meets the contract but misses the opening date has not really succeeded.
Health and safety documentation also lands here. The handover package should include the health and safety file required under CDM regulations, as set out by the Health and Safety Executive, along with operation and maintenance manuals and all commissioning certificates. A contractor who hands these over complete and on time saves the operator weeks of chasing.
Everything above describes a new build. Converting an existing retail or industrial unit into a supermarket changes the picture.
A conversion removes the groundworks and frame phases almost entirely, which can take 4 to 6 months out of the construction period. Planning is often faster too, because change of use within retail classes is simpler than building on open land. A well chosen conversion can go from acquisition to trading in 9 to 12 months against 18 to 30 for a new build.
The trade off is risk. Existing buildings hide problems. Structural capacity for new plant, floor slabs that cannot take cold room loads, asbestos, and roofs at the end of their life all surface during conversion works rather than before them. A thorough building survey before acquisition is the price of a fast conversion programme. Our retail refurbishment page covers how we approach existing buildings.
Lidl and Aldi open stores faster than almost anyone else in UK retail, and it is worth understanding why, because the lessons apply to any operator.
A standard discounter format new build typically completes its on site phase in around 5 to 7 months. That speed is not a corner cut. It is the compound effect of repetition, fixed decisions and a delivery team that has done it before. For more on how we deliver food retail schemes, see our supermarket construction page.
When a contractor gives you a programme, test it with these questions:
A contractor with real supermarket experience answers these in specifics. Vague answers now become delays later.
From a standing start, plan for 18 to 30 months to a trading new build supermarket, with 6 to 10 months of that on site. A conversion can trade within 9 to 12 months of acquisition. The construction phase is the most predictable part of the whole journey. The phases that wreck opening dates are planning, utilities and late decisions, and all three are manageable if they are taken seriously early.
The single best protection for your opening date is bringing delivery experience into the project before the programme is written, not after. A timeline built by people who have delivered the building before is a commitment. A timeline built from industry averages is a hope.
If you are planning a supermarket project and want a realistic programme based on stores we have actually delivered, get in touch. We will tell you what is achievable on your site, including the parts you might not want to hear.
